Silver Hill
America's First Significant Silver Discovery

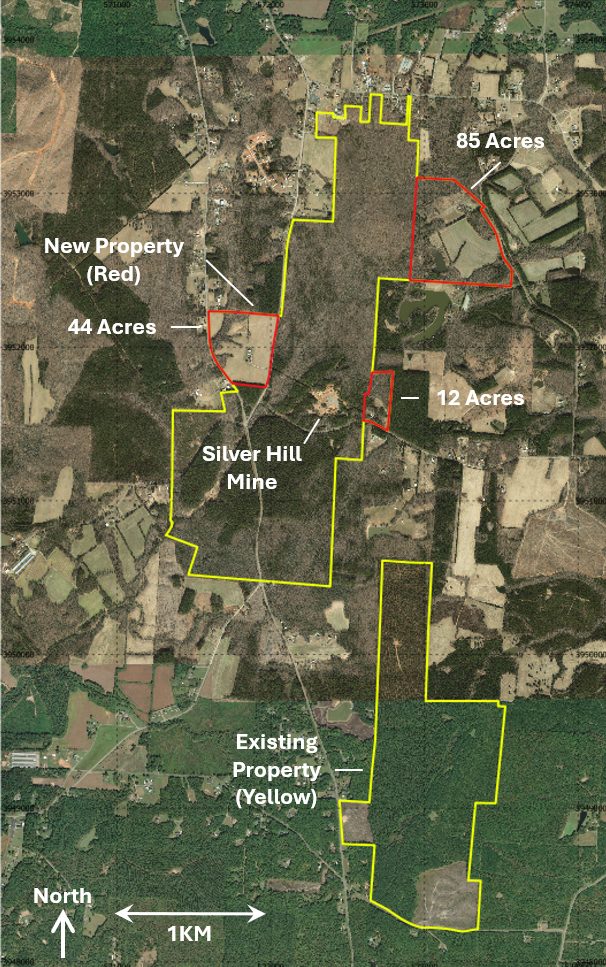

Davidson County, North Carolina — 1,300 Acres
Phase 1 Drilling
Metalsource’s phase 1 drill program at Silver Hill has delivered significant results, extending high-grade gold-silver-base metal mineralization 195m down dip, with visual confirmation of wide massive sulphide zones continuing both down dip and along strike.
- These intercepts represent previously unrecognized mineralization — historic work indicated only narrow mineralization and did not demonstrate gold grades of this tenor previously
- The historic workings at the 550 level and previous mapping and modelling projected this mineralization as a much narrower zone
- Ongoing exploration drilling will work to expand mineralization along strike and down plunge below the 1,000 level
*Equivalent grades calculated using 200-day moving average metal prices as of Feb. 6, 2026 (Au US$124.5/g, Ag US$1.58/g, Cu US$4.9/lb, Pb US$0.90/lb, Zn US$1.11/lb) and metallurgical recovery rates (Au 95.5%, Ag 92.9%, Cu 90.8%, Pb 89.2%, Zn 93.8%) derived from historical metallurgical test work on material from the Silver Hill mine. Recovery rates are based on historical processing data and may not be representative of in-situ mineralization. Equivalent grades are provided for comparative exploration purposes only. Widths reported are core length. See appendix for full results table.
Overview

The Silver Hill Project totals 1,225 acres located in Davidson County, North Carolina. The project area is entirely on privately owned land with no federal, state, or Native American ground, and features on-site roads, power and water.
Metalsource COO Tom Kleeberg and his team bring exceptional expertise on these properties, and their years of groundwork provide us with an invaluable platform for exploration.
Project History
*Underground diamond drilling. Widths reported are core length; true widths have not been determined. For complete drilling, sampling and analytical methodology, QA/QC procedures, and qualified person information (Darcy Vis), refer to the Company’s news releases filed on SEDAR+ at www.sedarplus.ca.

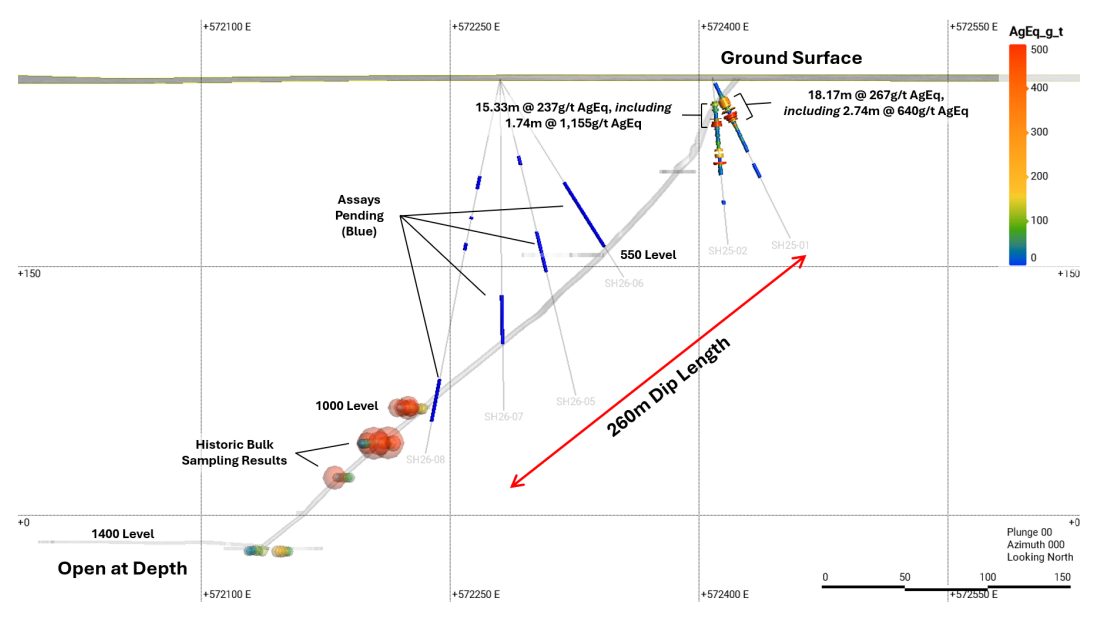

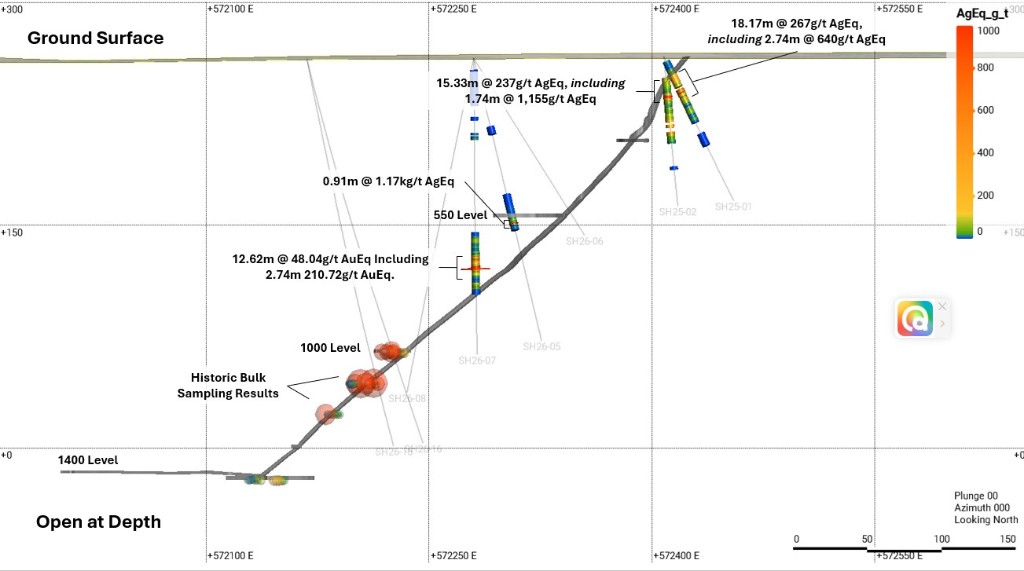

Phase 1 & Phase 2 Drill Results — As of July 16, 2026
| Drill Hole | From (m) | To (m) | Length (m) | Ag (g/t) | Au (g/t) | Cu (%) | Pb (%) | Zn (%) | AgEq (g/t)* |
|---|---|---|---|---|---|---|---|---|---|
| SH25-01 | 14.32 | 32.49 | 18.17 | 67.92 | 1.75 | 0.10 | 3.06 | 1.04 | 250.38 |
| Incl. | 24.69 | 32.49 | 7.80 | 66.12 | 3.22 | 0.14 | 3.58 | 0.87 | 365.17 |
| Incl. | 24.69 | 27.43 | 2.74 | 139.89 | 4.75 | 0.27 | 7.13 | 1.17 | 601.03 |
| SH25-02 | 14.23 | 29.57 | 15.33 | 33.22 | 2.09 | 0.05 | 1.11 | 1.37 | 223.58 |
| Incl. | 24.66 | 29.57 | 4.91 | 61.47 | 5.71 | 0.14 | 2.70 | 3.76 | 580.35 |
| Incl. | 26.40 | 28.13 | 1.74 | 68.70 | 13.15 | 0.08 | 2.92 | 0.47 | 1,097.88 |
| SH26-05 | 116.10 | 117.01 | 0.91 | 241 | 2.16 | 0.22 | 16.55 | 34.62 | 1,088.43 |
| SH26-07 | 129.91 | 142.52 | 12.62 | 42.32 | 46.54 | 0.12 | 1.39 | 3.26 | 3,611.91 |
| Including | 135.58 | 142.52 | 6.95 | 54.75 | 84.03 | 0.16 | 1.13 | 1.82 | 6,423.28 |
| And | 139.78 | 142.52 | 2.74 | 93.63 | 209.14 | 0.12 | 0.34 | 1.19 | 15,853.64 |
| SH26-08 | 186.05 | 199 | 12.95 | 42.5 | 1.3 | 0.2 | 6.5 | 13.4 | 417.21 |
| Including | 186.05 | 191.48 | 5.43 | 61.6 | 1.6 | 0.2 | 11.1 | 23.5 | 655.79 |
| Including | 188.37 | 191.48 | 3.11 | 94.1 | 2.2 | 0.3 | 17.2 | 36 | 987.27 |
| And | 196.44 | 199 | 2.56 | 74.8 | 2.1 | 0.3 | 8.8 | 15 | 562.64 |
| SH25-03 | 16.92 | 20.06 | 3.14 | 3.2 | 0.04 | 0.06 | 0.7 | 0.6 | 60 |
| Incl. | 16.92 | 18.41 | 1.49 | 1.4 | 0.06 | 0.05 | 0.5 | 0.1 | 67 |
| SH25-04 | 58.55 | 60.11 | 1.55 | 0.4 | 0.24 | 0.01 | 1.5 | 2.6 | 113 |
| Incl. | 59.56 | 60.11 | 0.55 | 103 | 0.7 | 0.03 | 3.9 | 6 | 279 |
| SH26-10 | 111.98 | 116.59 | 4.60 | 3.9 | 0.72 | 0.1 | 2.7 | 6.1 | 202 |
| Incl. | 116.01 | 116.59 | 0.58 | 46.8 | 1.2 | 0.36 | 13.6 | 17.6 | 656 |
| SH26-11 | 138.41 | 149.05 | 10.64 | 27 | 3.3 | 0.2 | 3.3 | 7.9 | 434 |
| Incl. | 139.96 | 149.05 | 9.08 | 30.3 | 3.7 | 0.2 | 3.7 | 8.5 | 488 |
| Incl. | 142.98 | 146.15 | 3.17 | 52.4 | 9.7 | 0.4 | 6.5 | 14.7 | 1,087 |
| Incl. | 142.98 | 144.51 | 1.52 | 192 | 19.1 | 0.5 | 11.7 | 25.1 | 2,050 |
| SH26-15 | 218.66 | 228.84 | 10.18 | 16.4 | 2.1 | 0.4 | 1.5 | 2.9 | 257 |
| Incl. | 218.66 | 219.36 | 0.70 | 59.5 | 8.3 | 0.4 | 0.4 | 1.4 | 1,039 |
| Incl. | 226.13 | 228.84 | 2.71 | 1 | 4.5 | 0.2 | 5.3 | 10.3 | 594 |
| SH26-16 | 224.45 | 233.02 | 8.56 | 7.7 | 0.6 | 0.09 | 0.8 | 2.1 | 90 |
| Incl. | 224.45 | 224.85 | 0.40 | 23.8 | 11.3 | 0.1 | 1.5 | 6 | 984 |
| Incl. | 232.87 | 233.02 | 0.15 | 146 | 0.4 | 0.09 | 18.8 | 39.4 | 951 |
| SH26-17 | 185.59 | 185.75 | 0.15 | 21.5 | 0.7 | 0.5 | 3.8 | 10.5 | 292 |
| SH26-18 | 199.40 | 211.23 | 11.83 | 34.3 | 1.4 | 0.1 | 2.2 | 5.4 | 245 |
| Incl. | 199.40 | 200.80 | 1.40 | 19.7 | 7.3 | 0.3 | 1.5 | 16 | 833 |
| Incl. | 199.40 | 200.04 | 0.64 | 36.8 | 13.8 | 0.7 | 2.7 | 29.8 | 1,580 |
| Incl. | 208.94 | 211.23 | 2.29 | 52.7 | 1.7 | 0.4 | 9.8 | 16 | 636 |
| SH26-19 | 218.60 | 224.88 | 6.28 | 54 | 9.9 | 0.1 | 3.7 | 21.7 | 1,156 |
| Incl. | 218.60 | 222.20 | 3.60 | 43.7 | 16.5 | 0.1 | 2.8 | 32.2 | 1,789 |
| Incl. | 224.00 | 224.88 | 0.88 | 157.3 | 2.7 | 0.3 | 10.8 | 18.9 | 762 |
| And | 227.93 | 228.23 | 0.30 | 64.6 | 3.3 | 0.3 | 4.2 | 15.9 | 609 |
Widths reported are core length, as additional data is needed to estimate the true width of intercepts at this stage of the project. AgEq (silver equivalent) and AuEq (gold equivalent) are calculated using 200-day moving average metal prices as of Feb. 6, 2026 (Au US$124.5/g, Ag US$1.58/g, Cu US$4.9/lb, Pb US$0.90/lb, Zn US$1.11/lb) and metallurgical recovery rates (Au 95.5%, Ag 92.9%, Cu 90.8%, Pb 89.2%, Zn 93.8%) derived from historical metallurgical test work on material from the Silver Hill mine. Recovery rates are based on historical processing data and may not be representative of in-situ mineralization. Equivalent grades are provided for comparative exploration purposes only and should not be interpreted as representing recoverable metal or economic value. Drill core samples were prepared and analyzed by ALS Geochemistry (Reno, NV) and ALS Canada (Vancouver, BC). The entire sample is crushed to 70% passing 2mm mesh, with a 250g split pulverized to 85% passing minus 75 microns. Gold was determined by fire assay; base metals by four-acid digestion with ICP-AES and ICP-MS finish. QA/QC protocols included certified reference standards, blanks, and duplicates inserted at regular intervals throughout the sample stream. The exploration results described herein are preliminary in nature and are insufficient to define a mineral resource. Further drilling is required to determine the continuity, geometry, and grade distribution of mineralization.
Next Steps

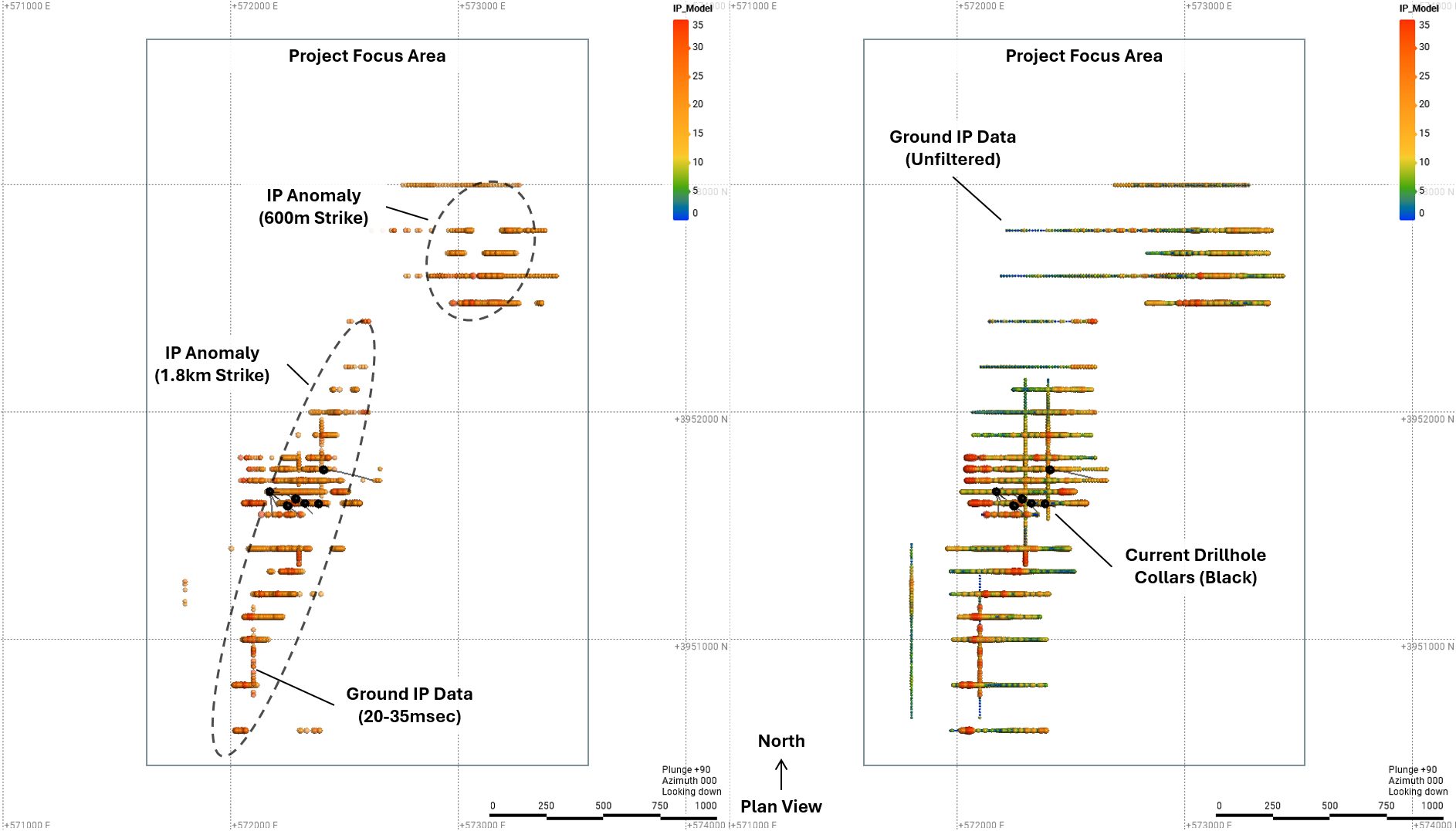

Building on Phase 1 drilling results and the recently completed Phase 2 IP survey, Metalsource is now aggressively advancing exploration at Silver Hill with plans to increase drilling capacity and systematically test newly identified high-priority targets.
This survey represents a major step forward in our understanding of the Silver Hill district. What excites us most is not simply the number of targets identified, but the quality of those targets. These targets exhibit geophysical characteristics analogous to the corridor where we've already delivered some of our strongest drill results. While these are exploration targets, not drill results, they provide us with a compelling pipeline of opportunities that we intend to begin testing as we continue to accelerate exploration. With plans to increase drilling capacity, our strategy is straightforward. One drill program will continue systematically expanding the known Silver Hill deposit, while additional drilling evaluates these newly identified high priority targets.
– Joe Cullen, CEO
